Restoration · Major renovation · In progress

Restoring a riad in the Rabat medina.

A listed riad in the heart of the medina: carved plaster decoration, painted cedar ceilings, original zellige. Structure to strengthen, floors to rebuild, services to install, without damaging the heritage.

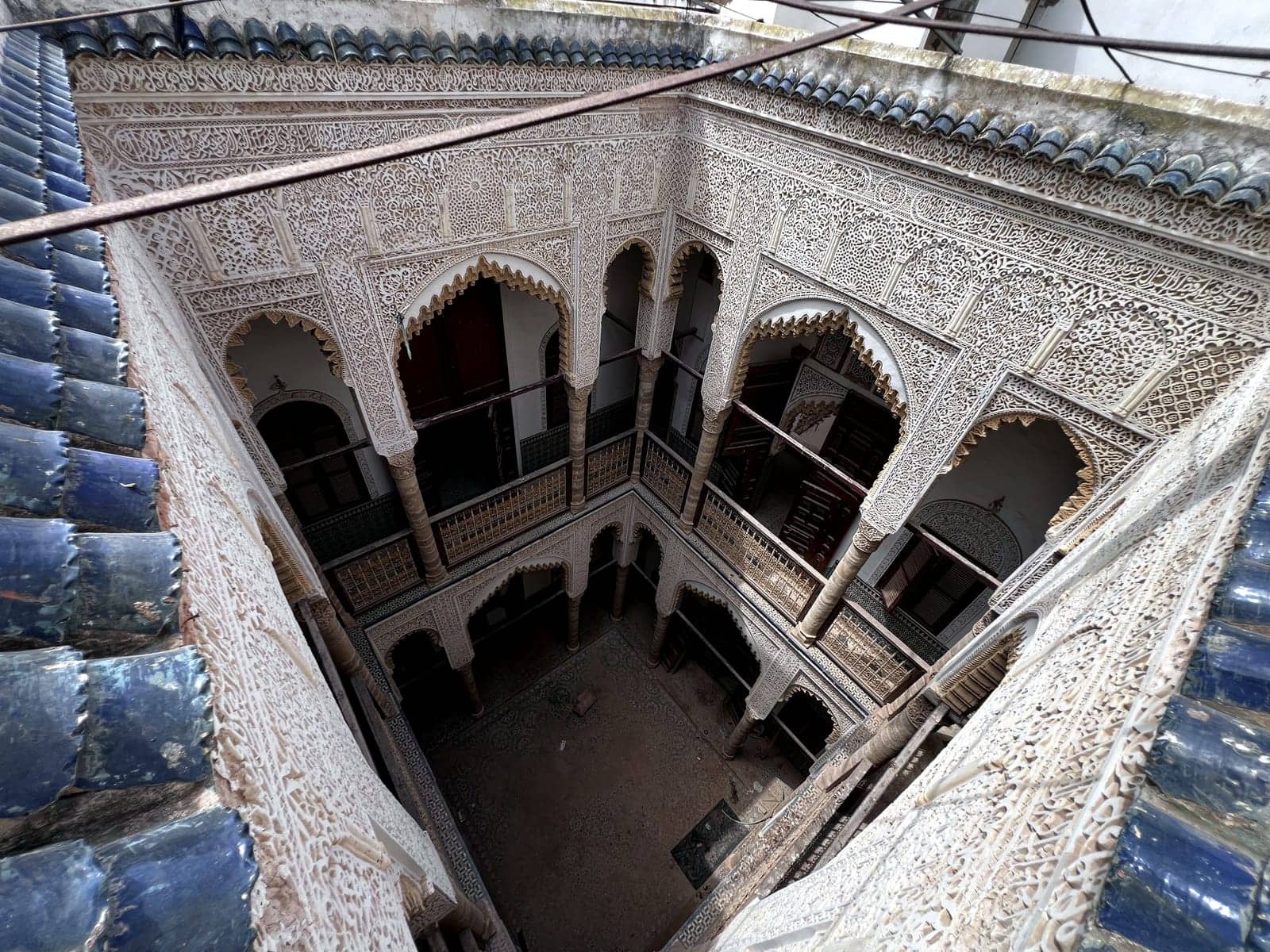

Courtyard of a riad in the Rabat medina with galleries, stone columns and carved plaster arches

Rabat medina · Since June 2026 · 12 months planned

The build

A riad on four levels, with a galleried courtyard, stone columns, carved plaster arches, painted cedar ceilings and original zellige panelling. Some of the timber floors have collapsed, the renders are coming away and the services are obsolete.

The contract covers nine work packages, from suspended ceilings to the tile layout of the floors, under the direction of an architect and with a structural engineering consultancy. The challenge: rebuild the structure and services while protecting every decorative feature, then restore the traditional finishes.

Work packages on this build.

  1. 01Masonry and strengthening
  2. 02Suspended ceilings
  3. 03Electrics
  4. 04Carved plaster
  5. 05Timber joinery
  6. 06Metalwork
  7. 07Wall finishes
  8. 08Floor finishes
  9. 09Tile layout

Site photos

[ 12 photos ]

What our visits show.

These photos come from our site visit reports, with their captions. They are published with the client’s consent.

Method

[ On this build ]

How we work here.

01

Protect before starting work

Sheeting stretched over the whole courtyard, nets under the painted ceilings, columns and capitals protected, joinery removed, wrapped and stored before the first chisel strike.

02

Strip back to understand

Renders are removed down to the stone and fired-clay brick to read the actual structure. The structural engineering consultancy rules on each defect before any repair.

03

Reuse what can be reused

The bejmat and zellige tiles removed are sorted and stored to be relaid. The original doors and mashrabiya screens are kept.

04

Decide in writing

Replacing the timber floors with solid slabs was approved on drawings and structural calculations by the architect and the structural engineering consultancy, then added to both schedules with the reason for the change.

Stages

[ In progress ]

The build, visit after visit.

  1. 16 June 2026

    Kick-off visit and condition survey

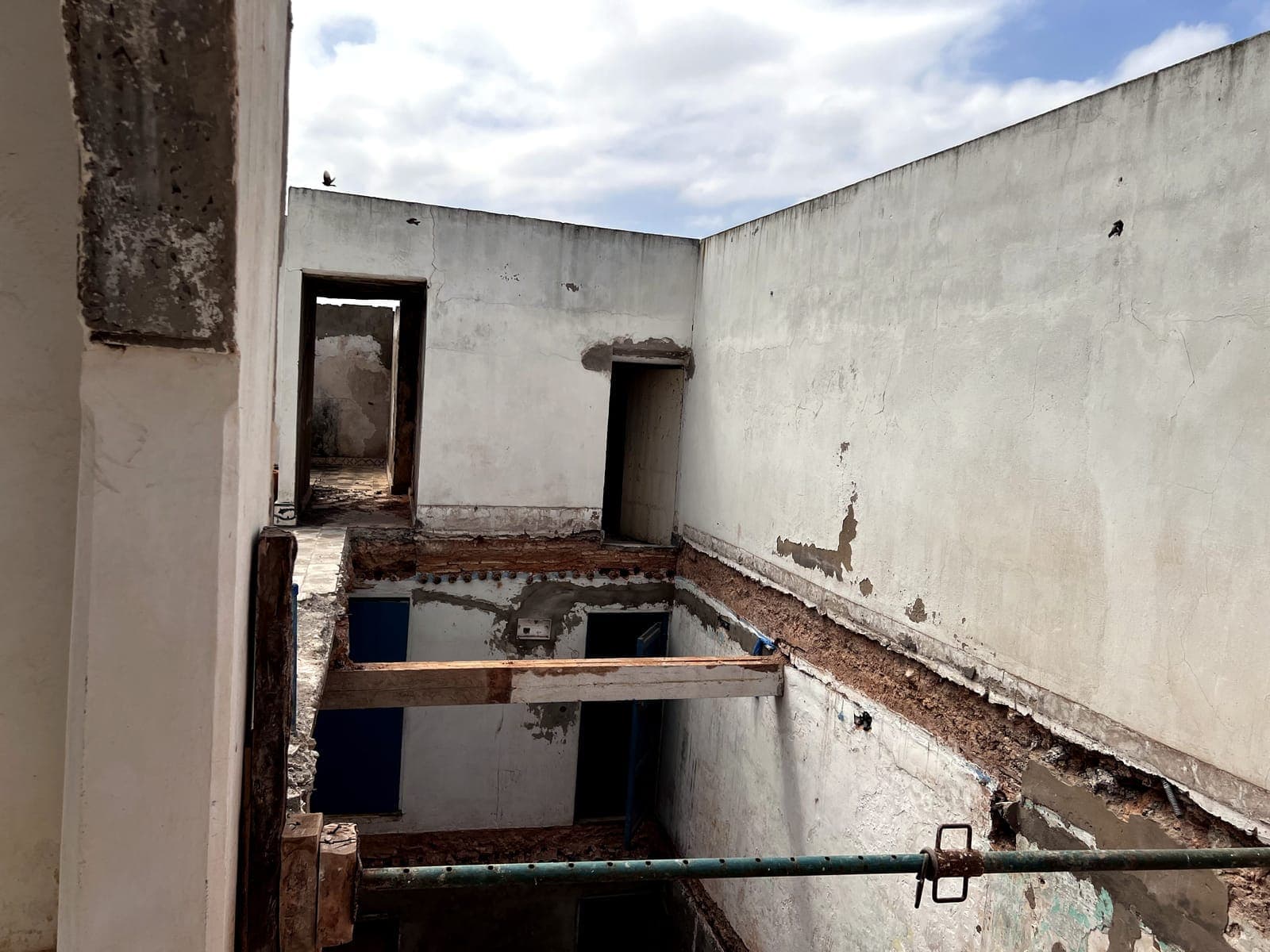

    Full photographic survey of the four levels, identification of the heritage features to protect, mapping of structural defects: collapsed floor, decayed roof timbers, cracks.

  2. 8 July 2026

    Protection and start of stripping

    Protection in place over the whole courtyard and the painted ceilings. Renders stripped from top to bottom in the reception rooms and circulation areas. Site office set up with the construction drawings by zone.

  3. 22 July 2026

    Stripping complete, floors lifted

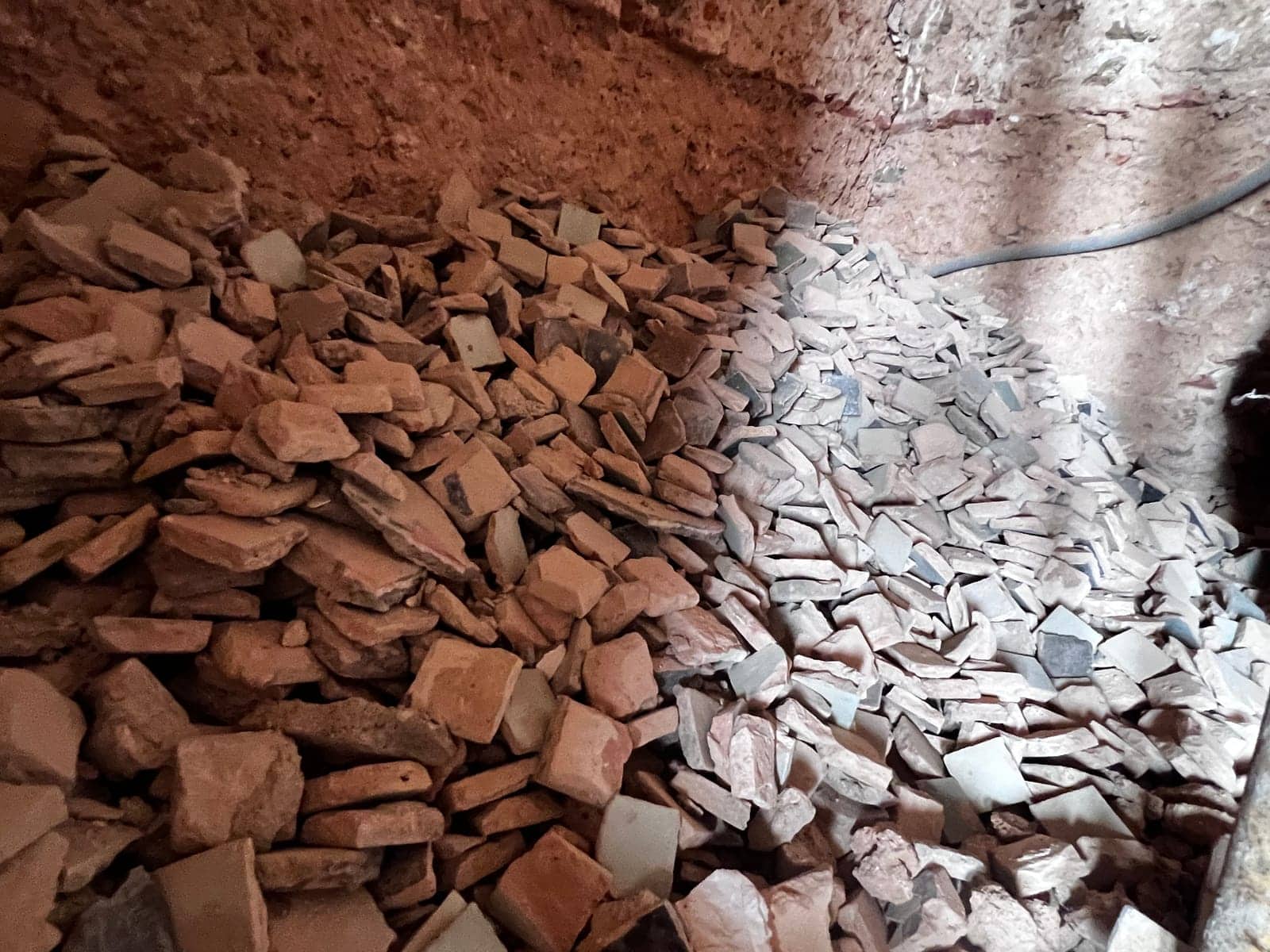

    Renders removed in most rooms, including the roof terrace. Bejmat lifted, sorted and stored for reuse. Reception room floors dug out for concealed services.

  4. 19 August 2026

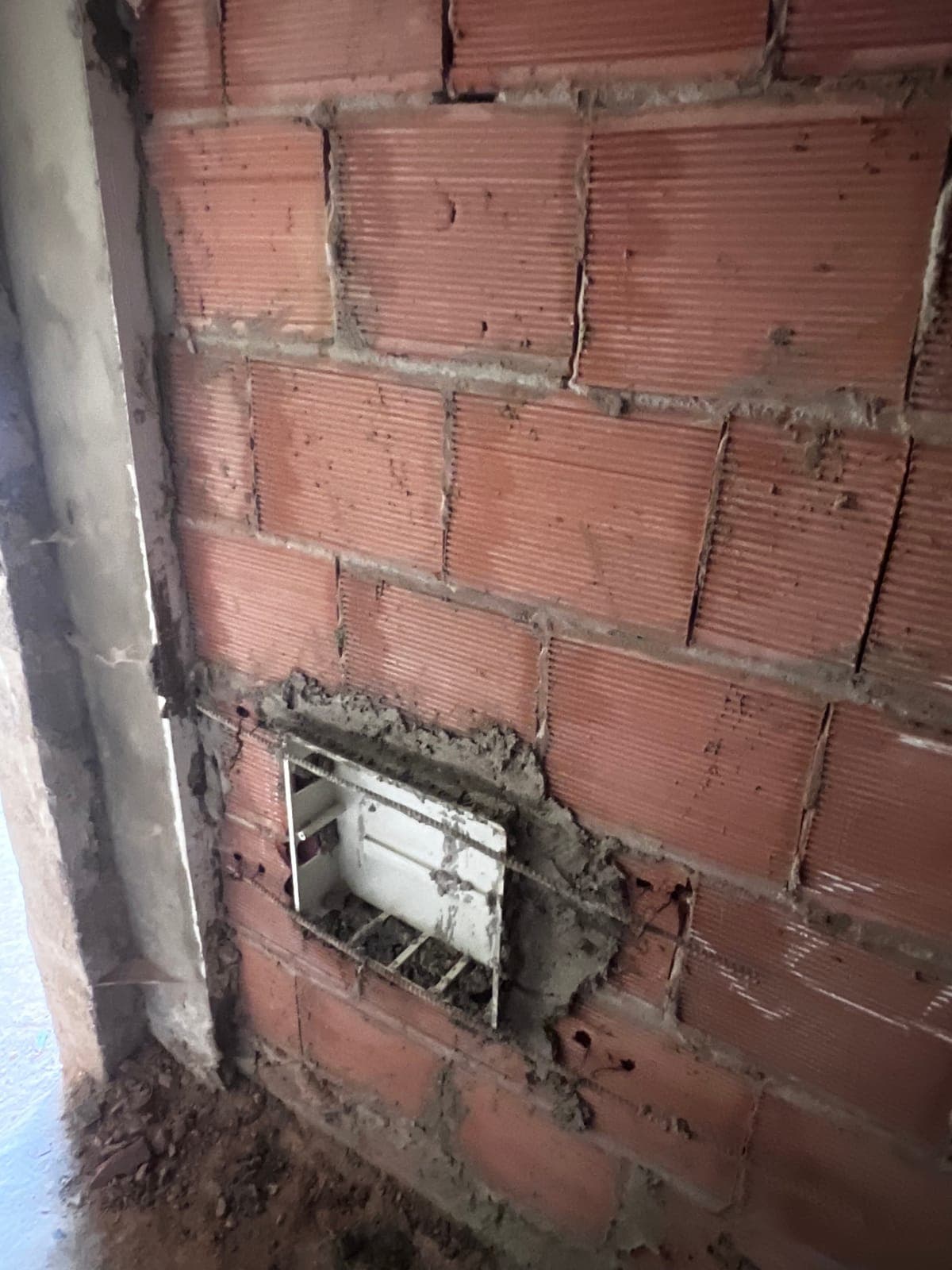

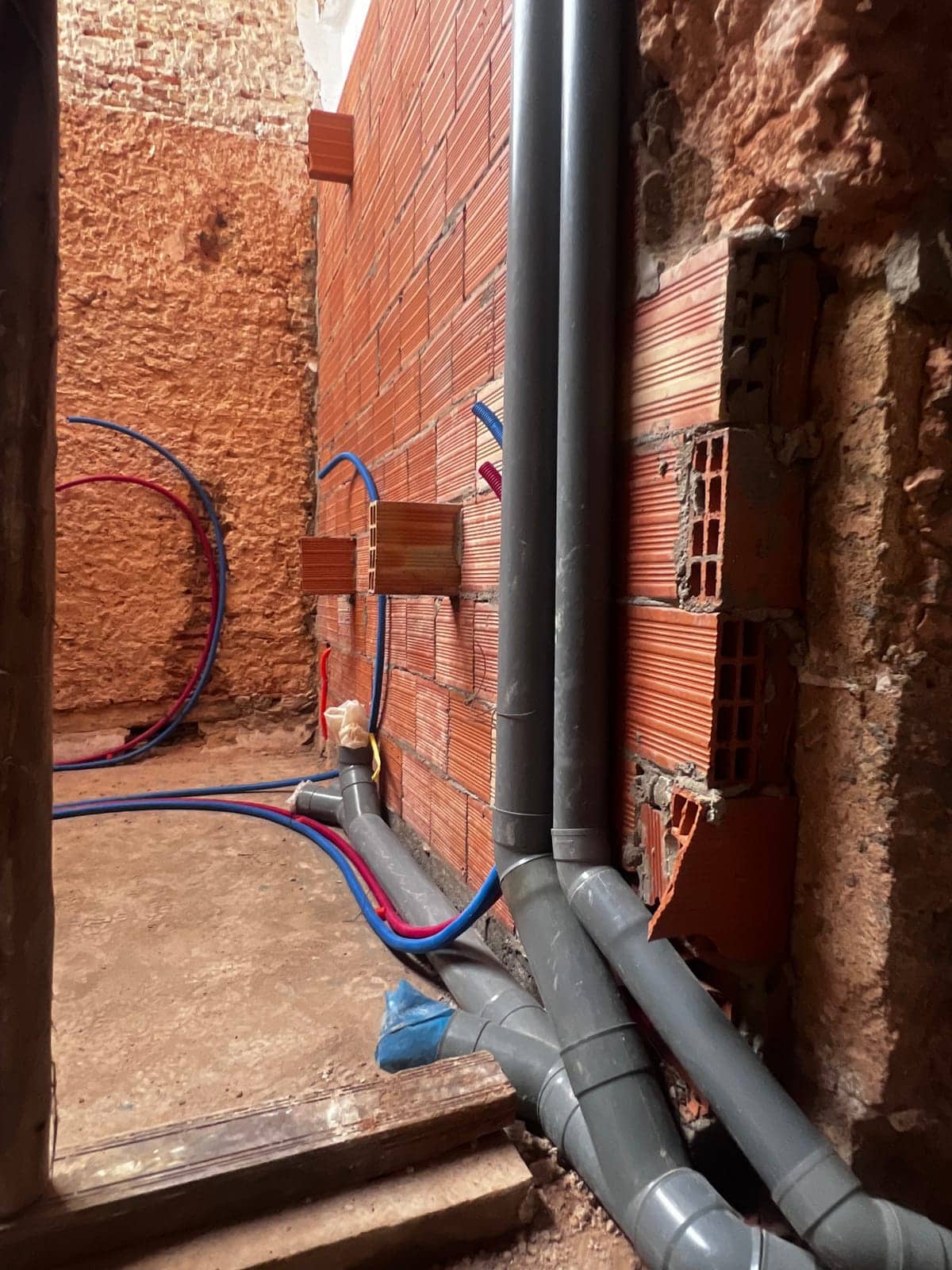

    Structural work, strengthening and first services

    Non-load-bearing partitions demolished, brick walls repaired, floors propped, lintels installed. Concealed services started zone by zone, ahead of schedule. Since then, the first slab has been poured, together with the first level of the lift shaft wall.
